|
Distributing Days Over Intervals
|
Excel is frequently used as a platform to build scheduling
applications. In these sort of applications, it may be useful to
determine how the period between the start date and the end date are distributed
across the intervening months or years. For example, if a project starts
on 12-February and ends on 28-June, how many days are used in each month?
And what about working days (Monday through Friday)?
Here, we'll look at a few formulas that will allow you do write these sorts
of schedules.
NOTE: Some of these formulas use the NETWORKDAYS
function, which returns the number of working days between two dates. This
function is part of the Analysis Tool Pack, so you must have this installed in
order to use these formulas. For more information about installing the
ATP, click here.
Distributing Working Days Across Months
You can distribute the number of working days between two dates over
the intervening months. See the table below, for an example.
|
|

| |
This shows how the number of dates between the Start Date in column B and the
End Date in column C are distributed over the months of the year.
For the dates show in row 6, 15-Jan-00 and 12-Jun-00, the number of working days
for each month in that interval are shown columns D through O.
The formula which computes these days is
=MAX(0,NETWORKDAYS(MAX(D$5,$B6),MIN(DATE(YEAR(D$5),MONTH(D$5)+1,0),$C6)))
This formula is entered in D5, and then we use Fill Down and Fill Right to
fill it through O7. It is important to use the relative and absolute cell
references (the $ in the cell names) so that when the formula is copied down and
to the right, the proper cells are referenced. If you are not familiar
with this type of cell referencing, refer to Relative
And Absolute Addressing.
The cells in D5:O5, which appear as month names, are actually real Excel
dates, representing the first day of that month. For example, D5 actually
contains the date 1-Jan-2000, but is formatted only to show
"Jan". The formula requires these cells to actual dates.
(You can enter Jan 2000 in a cell, and Excel will automatically convert
it to the serial date of the first day of that month and year).
To see how this formula works, let's break it apart. For any
month, we first find the larger (later) of the Start Date and the first day of
the month, with MAX(D$5,$B6). This
will always return the first day of the month (D$5)
except for the first month, in which case it will be the Start Date.
Then, we find the last day of the month. That's what DATE(YEAR(D$5),MONTH(D$5)+1,0)
does, by taking into account that the last day of one month is the 0th day of
the next month.
Next, we use the MIN function to find the smaller of the last day of the
month and the End Date. That's what MIN(DATE(YEAR(D$5),MONTH(D$5)+1,0),$C6)
does. For every month but the last month, this will always be the last day
of the month.
Then, we use the NETWORKDAYS
function to return the number of working days between these two dates (between
either the Start Date or the first of the month, and either the End Date of the
last of the month).
NETWORKDAYS(MAX(D$5,$B6),MIN(DATE(YEAR(D$5),MONTH(D$5)+1,0),$C6))
Since NETWORKDAYS will return a negative
number for months that are not included between Start Date and End Date at all,
we simply wrap the entire function in a MAX function, to return a zero if the
result of NETWORKDAYS is less that zero.
=MAX(0,NETWORKDAYS(MAX(D$5,$B6),MIN(DATE(YEAR(D$5),MONTH(D$5)+1,0),$C6)))
All of the functions on this page work in essentially the
same way, with some minor variations. I'm not going to describe each of
the others in as much detail. Remember,
the NETWORKDAYS function
can also take into account a list of holidays to exclude from the count.
Suppose you had a list of holidays in T1:T20, you could exclude these from the
result by changing the formula to: =MAX(0,NETWORKDAYS(MAX(D$5,$B6),MIN(DATE(YEAR(D$5),MONTH(D$5)+1,0),$C6),$T$1:$T$20))
See the online help for NETWORKDAYS
to learn more about this.
You can have more than the 12 months as shown in the example, and the first
month does not need to be January. For example if your Start Date is in
June-2000, and your end date is in March-2003, you start with June-2000 in D5
and extend that our for 34 columns to AK5, which would contain March-2003.
Nothing in the formula requires 12 or fewer months, or that the dates be in the
current year. It will work properly for any number of months (up to 256,
which is the limit of the number of columns in Excel).
Distributing All Days Across Months
In the previous section, we used the NETWORKDAYS
function to count only working days. To count all of the days between the Start
Date and End Date, including weekends and holidays, simply use
=MAX(0,(MIN($C17,DATE(YEAR(D$16),MONTH(D$16)+1,0))-MAX($B17,D$16)+1))
instead of the the function in the previous section. This will count
all of the days, not just the working days. See the sample data below for
an example:
|
|
|
|
|

|
This formula works essentially the same as the formula in the previous
section, but uses subtraction instead of NETWORKDAYS
to count the number of days.
You can have more than the 12 months as shown in the example, and the first
month does not need to be January. For example if your Start Date is in
June-2000, and your end date is in March-2003, you start with June-2000 in D5
and extend that our for 34 columns to AK5, which would contain March-2003.
Nothing in the formula requires 12 or fewer months, or that the dates be in the
current year. It will work properly for any number of months (up to 256,
which is the limit of the number of columns in Excel).
Distributing Working Days Across Years
The previous sections explained how to distribute the days in an interval
over a number of months. You can also do something similar to distribute
the working days between Start Date and End Date over years, instead of
months. In the example below, the interval between Start Date and End Date
is distributed of the years 2000 to 2002 and 2003 and 2009.
|
|

| |
This formula works in a similar manner to the formula in the first
section. However, the year values in D5 to O5 are not Excel serial
dates. The actual value of the cell is the year number. For example,
D27 contains the number 1000. The formula used to distribute the days over
the years is =MAX(0,NETWORKDAYS(MAX(DATE(D$27,1,1),$B28),MIN(DATE(D$27,12,31),$C28))) This
formula works for each year by first determining the larger (later) of the
Start Date ($B28) and
the first day of the year with the function MAX(DATE(D$27,1,1),$B28).
This will be the first day of the year for all years except the first.
Then, it determines the earlier (smaller) of the the End Date and the last day
of the year with the function MIN(DATE(D$27,12,31),$C28)).
This will be the last day of the year for all years except the last. Next, it
uses the NETWORKDAYS
function to determine the number of working days between the these two
dates: NETWORKDAYS(MAX(DATE(D$27,1,1),$B28),MIN(DATE(D$27,12,31),$C28)) Since
NETWORKDAYS may return
a negative number, we wrap the entire function in a MAX
to return a zero if NETWORKDAYS
returns a negative number: =MAX(0,NETWORKDAYS(MAX(DATE(D$27,1,1),$B28),MIN(DATE(D$27,12,31),$C28)))

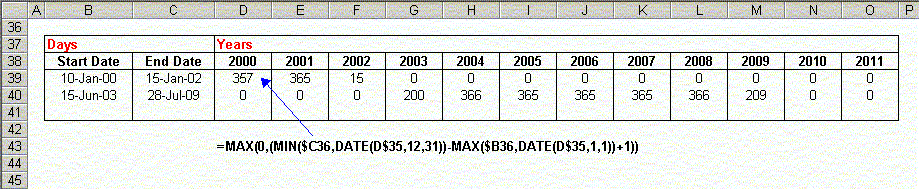

Distributing All Days Across Years
Finally, you may want to distribute all days, not just the
working days, across a number of years. The formula to do this is =MAX(0,(MIN($C39,DATE(D$38,12,31))-MAX($B39,DATE(D$38,1,1))+1)) as
shown in the following example.
|
|
|
This formula works essentially the same as the formula in the previous
section, but uses subtraction instead of NETWORKDAYS
to count the number of days.
You can download a file
illustrating these formulas (10KB zipped).
|
|
|
